Vietnam starts construction on the $910M Vinh-Thanh Thuy expressway linking Laos to seaports. Deo Cao Group leads the consortium. Completion by 2029 is the key revenue catalyst for the contractor and a milestone for cross-border trade.
Vietnam has started construction on the Vinh-Thanh Thuy expressway, a $910 million segment of the planned Hanoi-Vientiane corridor that will connect landlocked Laos to Vietnamese seaports. The project, approved by the National Assembly in December 2025 under a public investment resolution, is scheduled for completion by 2029. A consortium led by Deo Cao Group, one of the country's largest infrastructure builders, holds the main construction contract.

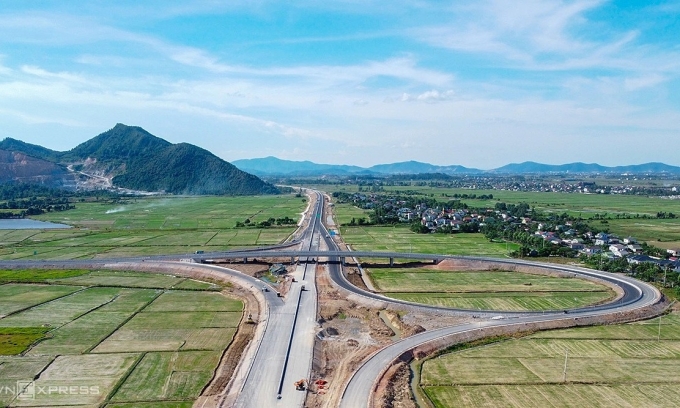

The expressway begins at the Hung Tay interchange in Nghe An Province, linking to the Dien Chau-Bai Vot section of the eastern North-South Expressway, and ends at the Thanh Thuy-Nam On border gate on the Laos frontier. The first phase will build four lanes on a six-lane design. Design speeds range from 100 to 120 kph on main sections and 60 to 80 kph through difficult terrain. Major bridges and the most challenging terrain will be constructed to the six-lane standard from the start.
For Laos, Southeast Asia's only landlocked country, the expressway promises a faster overland link to Vietnamese seaports. For Vietnam, it deepens trade, tourism and logistics ties with Laos and, beyond it, Thailand, as part of a broader east-west economic corridor. The Vietnamese leg of the corridor runs about 370 kilometers, roughly 310 of which overlaps the existing North-South Expressway. Once finished, the expressway is expected to sharply cut travel time between the Thanh Thuy border gate and Nghe An's cities and seaports. It also opens easier access to tourism sites such as Cua Lo beach, Pu Mat National Park and the Kim Lien relic site preserving President Ho Chi Minh's birthplace.
Builders will construct 51 bridges, 58 underpasses for local traffic, six interchanges, and a 485-meter tunnel bored through the Dai Hue mountain range with two separate tubes for opposing traffic. The project requires about 582 hectares of land, including nearly 98.5 hectares of headwater protection forest, 141 hectares of production forest and more than 221 hectares of rice fields.
| Component | Quantity |
|---|---|
| Total length | 370 km (310 km overlaps North-South Expressway) |
| Bridges | 51 |
| Underpasses | 58 |
| Interchanges | 6 |
| Tunnel | 485 m (two tubes) |
| Land required | 582 ha (including 98.5 ha headwater forest, 141 ha production forest, 221 ha rice fields) |
Deo Cao Group leads the consortium executing the construction. The company has a track record in large-scale Vietnamese infrastructure, including tunnels and expressways. For a stock with direct project exposure, this contract provides multi-year revenue visibility through 2029. The public investment funding structure reduces payment risk relative to public-private partnerships where revenue depends on traffic guarantees.
Execution risk centers on the tunnel and the diverse terrain that includes forest, rice fields and mountain areas. Land acquisition for 582 hectares, including 98.5 hectares of headwater protection forest, may face regulatory delays. The consortium must also coordinate the six-lane design for major bridges and difficult stretches while building only four lanes in the first phase.
The expressway is one of several large projects driving construction demand through the end of the decade. For investors tracking Vietnamese construction and logistics stocks, the project signals continued government spending on cross-border connectivity. Deo Cao Group's ability to deliver on time will influence sentiment toward the sector. The broader infrastructure theme can be tracked through our stock market analysis coverage of Vietnam's public investment cycle.
Nearly 40% of the required land – 221 hectares of rice fields and 98.5 hectares of headwater protection forest – involves sensitive categories. Headwater forests are protected under Vietnamese environmental law. Clearance may require additional permits or compensation negotiations with local communities. The production forest area (141 hectares) adds further complexity. Land acquisition delays are a common bottleneck in Vietnamese infrastructure projects. The 2025-2029 timeline assumes smooth progress on this front.
The 485-meter tunnel through the Dai Hue mountain range is the single most technically demanding element. Separate tubes for opposing traffic reduce collision risk during construction, the dual-bore design increases excavation volume. Deo Cao Group's prior tunnel experience lowers the execution probability of major setbacks. A setback at the tunnel would be the highest-impact delay risk for the entire corridor.
The start of construction marks the transition from planning to execution. Traders should monitor quarterly updates on progress, particularly tunnel boring milestones and bridge construction. Land acquisition progress for the rice fields and forest areas will be the lead indicator of regulatory friction. Faster-than-expected progress on the first phase would shorten the timeline to revenue recognition for Deo Cao Group.
The expressway is scheduled for completion by 2029. That year is the earliest point at which the corridor's economic benefits – faster freight transit from Laos to seaports, increased tourism revenue for Nghe An Province – become measurable. For Deo Cao Group, the completion triggers final payments and potential follow-on contracts from the Vietnamese government's broader connectivity plan.
Bottom line for traders: The project adds a concrete multi-year catalyst to Deo Cao Group's outlook. Valuation will depend on execution versus the 2029 deadline. Monitor land clearance news and quarterly construction updates as lead indicators of timeline risk.
