A JV wins the first $1B segment of ALCOSAN's 16-mile tunnel program. Execution in mixed geology under an urban river is the key risk. Start later this year.
A joint venture of Lane Construction Corp. and Brayman Construction Corp. has been selected for the Ohio River Tunnel project in Pittsburgh. The $1 billion contract is the first major component of the Allegheny County Sanitary Authority’s long-term program to reduce combined sewer overflows and protect regional waterways.
Work is scheduled to start later this year with a five-year timeline. The contract covers construction of nearly 5 miles of deep tunnels that will channel wet-weather flows to a new pump station at ALCOSAN’s North Side wastewater treatment plant. For Lane (the U.S. subsidiary of Webuild Group) and Brayman, the award adds a large, multi-year backlog. For investors tracking infrastructure spending, the project tests whether large urban tunnel boring work can stay on budget in a rising cost environment.

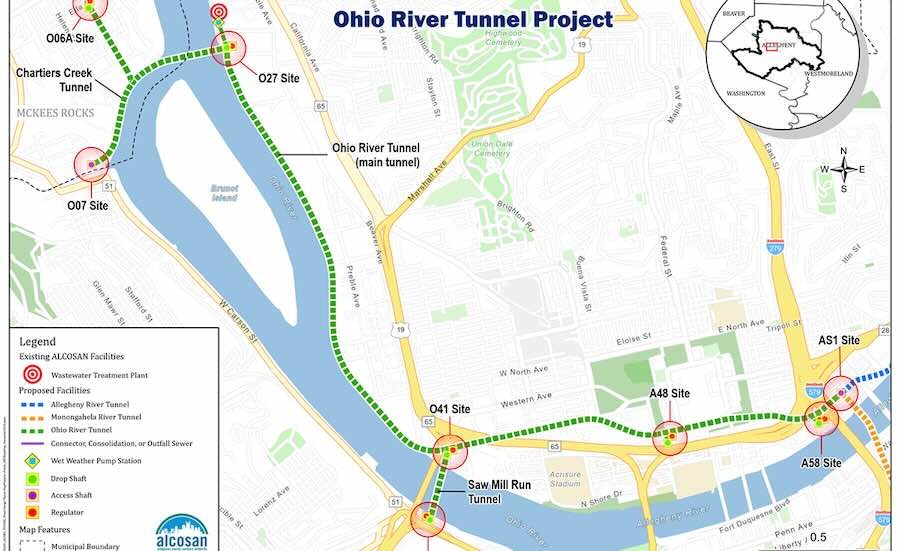

The main tunnel will be 18 ft in diameter, excavated by a tunnel boring machine at depths of 118 to 150 ft along a 3.8-mile route under the Ohio River. Two secondary tunnels – 14 ft in diameter, measuring approximately 4,500 ft and 500 ft – will feed into the main line. A 600-ft dewatering tunnel at the treatment plant completes the underground network.
Above ground, the scope includes eight deep shafts ranging from 25 to 70 ft in diameter, ten flow regulator structures, two technical buildings, and a new river outfall. Once operational, ALCOSAN says the system will capture excess wet-weather flows and reduce combined sewer overflows by approximately 7 billion gallons annually. The infrastructure is designed for a 100-year service life.
Lane Construction leads project management and major tunneling operations. Brayman, headquartered in Pittsburgh, oversees heavy civil work and shaft construction. For Webuild Group, the contract adds significant North American tunneling backlog in an environment of rising federal infrastructure spending. For Brayman, it reinforces its position in deep excavation and shaft construction in its home market.
Neither company publicly discloses project-level margins. Large-diameter tunnel boring contracts typically carry wider margin variance than surface construction due to geology risk, equipment downtime, and labor challenges. The joint venture structure spreads the risk. A significant cost overrun or delay would hit both partners.
The tunnel boring machine will operate in mixed geology beneath an urban river. That setting has caused schedule overruns on similar projects in Seattle, Washington D.C., and other U.S. cities. Utility conflicts, groundwater control, and shaft construction in a constrained riverfront site add complexity. A five-year timeline for a 3.8-mile main tunnel at those depths is aggressive, especially given current shortages of skilled tunneling labor in the U.S.
ALCOSAN’s long-term regional tunnel program includes two additional deep tunnels, tentatively scheduled over the next 15 years, for a total of 16 miles of wet-weather tunnel, 40 regulators, and more than 30 shafts. The Ohio River Tunnel is the first test case. Smooth execution would strengthen the case for accelerating later phases. Significant delays or cost overruns could slow the program and pressure ALCOSAN’s financing plan.
The project is part of a multi-billion-dollar regional investment in water infrastructure, reflecting a nationwide push to upgrade aging sewer systems under EPA consent decrees. For investors watching infrastructure spending, the award signals that large-scale tunneling contracts are moving forward despite rising material costs and labor shortages. Direct stock impact is limited: Lane and Brayman are not publicly traded in the U.S., and Webuild (listed in Milan) is a small component of most infrastructure ETFs. The real read-through is for municipal bond markets, where ALCOSAN’s debt issuance funds the program.
Key components of the Ohio River Tunnel:
Construction start later this year is the first milestone. Progress updates on tunnel boring machine launch, shaft excavation, and any change orders will be the primary signals for stakeholders. For ALCOSAN, the success of this tunnel will determine the pace and cost of the remaining 11 miles of planned tunnels. For the joint venture, on-time completion within budget would open the door to follow-on work in the same program.
