Koné oxide pour now late Q4-2026. $440.2M liquidity covers $380.1M remaining capex; buffer narrows after April Wheaton draw. Q2 resource updates next catalyst.
Montage Gold Corp. pulled forward the first gold pour at its Koné project in Côte d'Ivoire to late Q4-2026, advancing the oxide circuit ahead of schedule while keeping construction on-budget. The accelerated timeline shifts MAUTF closer to production revenue. The remaining $380.1 million in capital expenditure to full completion keeps execution risk central to the investment case.

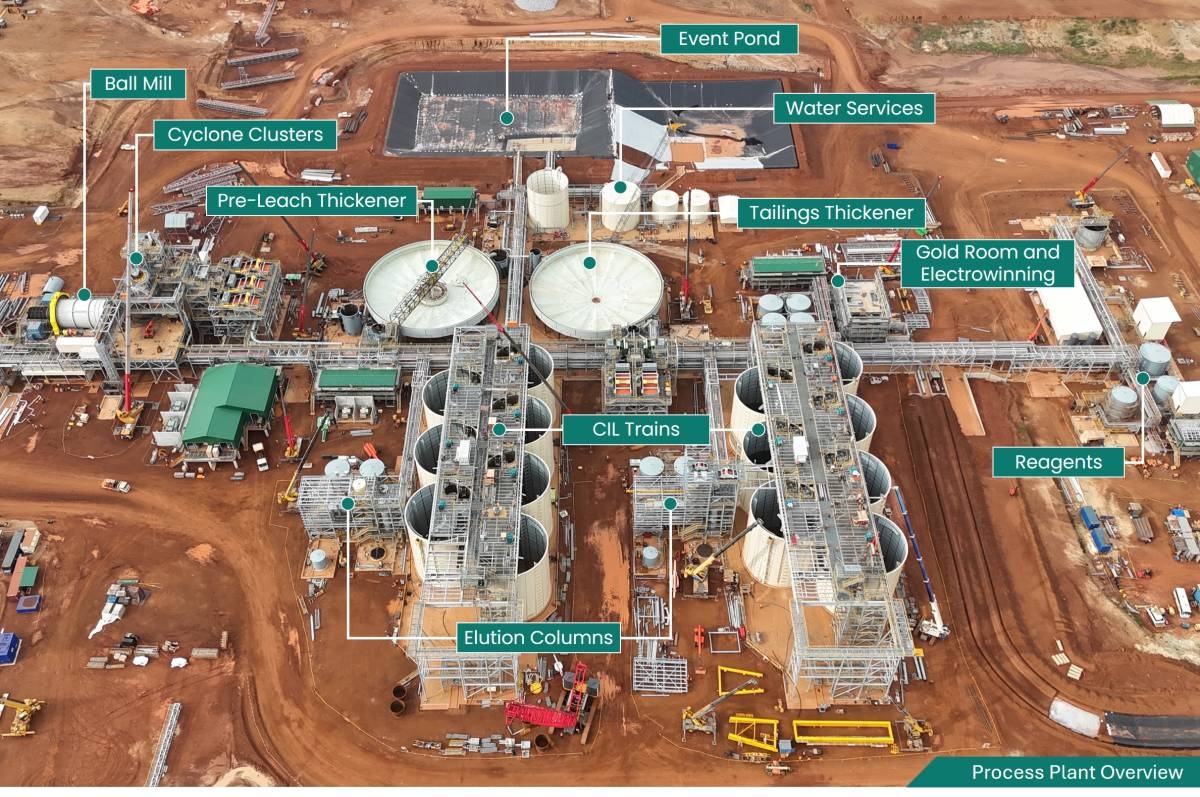

Montage completed installation of all major mill components during the first quarter. The oxide sizer is finished, reagent tanks are erected, and the pre-leach thickener shell is in place. Hydro-testing of the carbon-in-leach tanks is complete, and agitator, gearbox, inter-tank screen, and launder system installation is now underway, tracking ahead of the original schedule.
The oxide circuit start-up is the critical path to first revenue. With the mill and CIL trains advancing faster than planned, Montage now targets a first gold pour in late Q4-2026, ahead of the prior schedule. The company has committed $636.9 million of the total $885.0 million capital expenditure estimate as of the report date, representing 72% of the budget, with costs described as in line with expectations.
The hard rock comminution circuit remains on schedule for completion in Q2-2027. Civil works are progressing across the primary crusher, secondary crusher, and high-pressure grinding rollers. The tailings storage facility is nearing completion, with HDPE liner installation over 90% complete. The 225kV electrical substation and grid connection work is also on schedule, with all towers erected and power line stringing well underway.
The project has now logged over 10.4 million total construction hours since commencement. The Lost Time Injury Frequency Rate of 0.11 sits well below industry averages for large-scale African construction projects, a data point that reduces the operational risk of a safety-related work stoppage.
Montage ended the quarter with a consolidated cash balance of $79.4 million, down from $191.8 million at year-end 2025. The $112.4 million decrease was driven primarily by $120.6 million in investment in mineral properties, plant, and equipment related to Koné, partially offset by $10.6 million in proceeds from the disposal of marketable securities.
Total liquidity and Koné project funding sources stood at $440.2 million as of March 31, 2026. The components are:
| Funding Source | Amount ($M) | Status |
|---|---|---|
| Undrawn Wheaton Stream | 156.3 | Drawn April 10, 2026 |
| Undrawn Zijin Loan Facility | 50.0 | Available |
| Undrawn Wheaton Loan Facility | 75.0 | Available |
| Undrawn AFG Working Capital Facility | 50.0 | Closed April 17, 2026 |
| Cash on hand | 79.4 | As of March 31, 2026 |
| Other liquid assets | 29.6 | As of March 31, 2026 |
| Total liquidity | 440.2 | |
| Additional CAT Equipment Financing | 72.3 | Undrawn, tied to equipment |
The $156.3 million Wheaton Stream was drawn on April 10, 2026, reducing the undrawn balance after quarter-end. The $50.0 million AFG Working Capital Facility closed on April 17, 2026. The $72.3 million CAT Equipment Financing from Caterpillar Inc. (CAT) remains undrawn and is tied to equipment purchases.
Cash flows used in investing activities totalled $110.3 million in Q1-2026, a $3.6 million decrease from $113.9 million in Q4-2025. The variance was primarily driven by $10.6 million in proceeds from disposal of marketable securities, offset by the timing of cash outflows related to construction expenditures at Koné. Financing activities used $0.1 million in Q1-2026, compared to $157.3 million generated in Q4-2025 when $156.25 million of the Wheaton Stream was drawn down.
A total of $504.9 million had been disbursed for Koné construction as of quarter-end, including $137.9 million in Q1-2026. Montage estimates $280.1 million remaining to be disbursed until first gold pour through the oxide circuit, and a total of approximately $380.1 million remaining to full completion of the hard-rock circuit, inclusive of contingencies.
Montage drilled 47,254 meters at the Koné project in Q1-2026, with efforts focused on infill and extension drilling, advancing pre-resource targets, and testing new targets. The company expects to publish updated Mineral Resource Estimates for satellite deposits and maiden estimates for new discoveries in Q2-2026.
The satellite deposits targeted for updated resource estimates include:
New discoveries expected to receive maiden resource estimates include Petit Yao, Soman 1 & 2, and Lokolo West. These higher-grade satellites are intended to supplement production from the onset of mining.
Montage closed the acquisition of African Gold Limited on April 29, 2026, adding the Didievi project in Côte d'Ivoire. A 40,000-meter drill program launched in 2025 is nearing completion, with results expected in late Q2-2026, followed by an updated Mineral Resource Estimate. The Didievi asset adds a second potential development project to the pipeline.
Exploration has begun on recently secured greenfield properties. At the Wendé property in Côte d'Ivoire, a 9,000-meter drill program is underway. In Mauritania, early reconnaissance work is progressing at the Sfariat and Zednes properties. The 2026 group exploration budget, excluding African Gold assets, is $18.0 million for 99,000 meters of drilling and non-drilling activities.
The primary risk for Montage is execution. The company must disburse $380.1 million over the next several quarters while maintaining the construction schedule and budget. Any material cost overrun would pressure the liquidity buffer, particularly given that a portion of the undrawn facilities is already earmarked for specific purposes.
The liquidity position appears adequate on paper. The risk lies in the timing and conditions attached to the undrawn facilities. The $50.0 million Zijin Loan Facility and $75.0 million Wheaton Loan Facility are subject to conditions precedent. The $72.3 million CAT Equipment Financing is tied to equipment purchases. A delay in any drawdown could create a short-term cash crunch during a period of heavy construction spending.
Côte d'Ivoire has been a stable jurisdiction for gold mining. Frontier risk cannot be ignored. Montage's expanding footprint into Mauritania adds a second country risk layer. Operational risks include potential supply chain disruptions, labour issues, and the inherent uncertainty of ramping up a large-scale processing plant. The oxide circuit start-up is a critical test of the company's operational capability.
Montage Gold carries an Alpha Score of 65/100, labelled Moderate in the Basic Materials sector. The score reflects the company's progress toward production, balanced against the remaining capital requirement and single-asset concentration risk. The MAUTF stock page provides the full scoring breakdown.
A successful first gold pour in late Q4-2026, on budget, would validate the construction team and begin generating cash flow. The company also plans to publish an updated life of mine plan later this year, incorporating updated resources from Koné, Gbongogo Main, and higher-grade satellite deposits, along with the oxide circuit, plant design enhancements, and the shift to an owner-operated mining model. A revised LOM that demonstrates a lower all-in sustaining cost profile and extended mine life would support a re-rating.
Positive resource updates from the satellite deposits and maiden estimates for new discoveries in Q2-2026 could add near-mine ounces that are quickly convertible into reserves. The Didievi resource update later in the year would provide a second leg to the growth story. Strong drill results would reduce the reliance on Koné alone and support the multi-asset producer narrative.
Several developments would weaken the investment case. A delay in the oxide circuit start-up beyond Q4-2026 would push out first revenue and increase the funding requirement. Cost overruns that exceed the contingency would force Montage to seek additional capital, potentially dilutive to equity holders. A failure to draw down the remaining undrawn facilities on schedule would signal lender caution. Disappointing resource updates or lower-than-expected grades at the satellite deposits would undermine the thesis of supplementing production with higher-grade feed from the outset.
As a pre-production gold developer, Montage is highly sensitive to the gold price. A sustained drop below the price deck used in the feasibility study would compress margins and could make the remaining capex harder to finance. The gold profile provides context on the macro drivers. The company's fixed-cost construction budget provides some insulation. The revenue side remains fully exposed to spot gold once production begins.
Traders should monitor the quarterly cash balance and the pace of disbursements. The Q1-2026 cash burn of $112.4 million was in line with the heavy construction phase. A significant acceleration in spending without a corresponding drawdown of facilities would be a warning signal. The next quarterly report will show whether the April draw of the Wheaton Stream restored the cash buffer to comfortable levels.
The Koné project is entering the final stretch toward first gold. The construction progress is tangible, and the funding package is structured. The risk now shifts from "can they build it" to "can they finish it on time and on budget while bringing exploration ounces into the mine plan." For traders, the Q2-2026 resource updates and the updated LOM later in the year are the next concrete catalysts that will either confirm the de-risking trend or expose the remaining gaps.
