Canyon Resources delivered seven locomotives to Cameroon for its Minim Martap bauxite project. First shipment is targeted for Q4 2026, but a US$160 million funding gap limits Stage 2 expansion.
Alpha Score of 67 reflects moderate overall profile with strong momentum, strong value, weak quality, moderate sentiment.

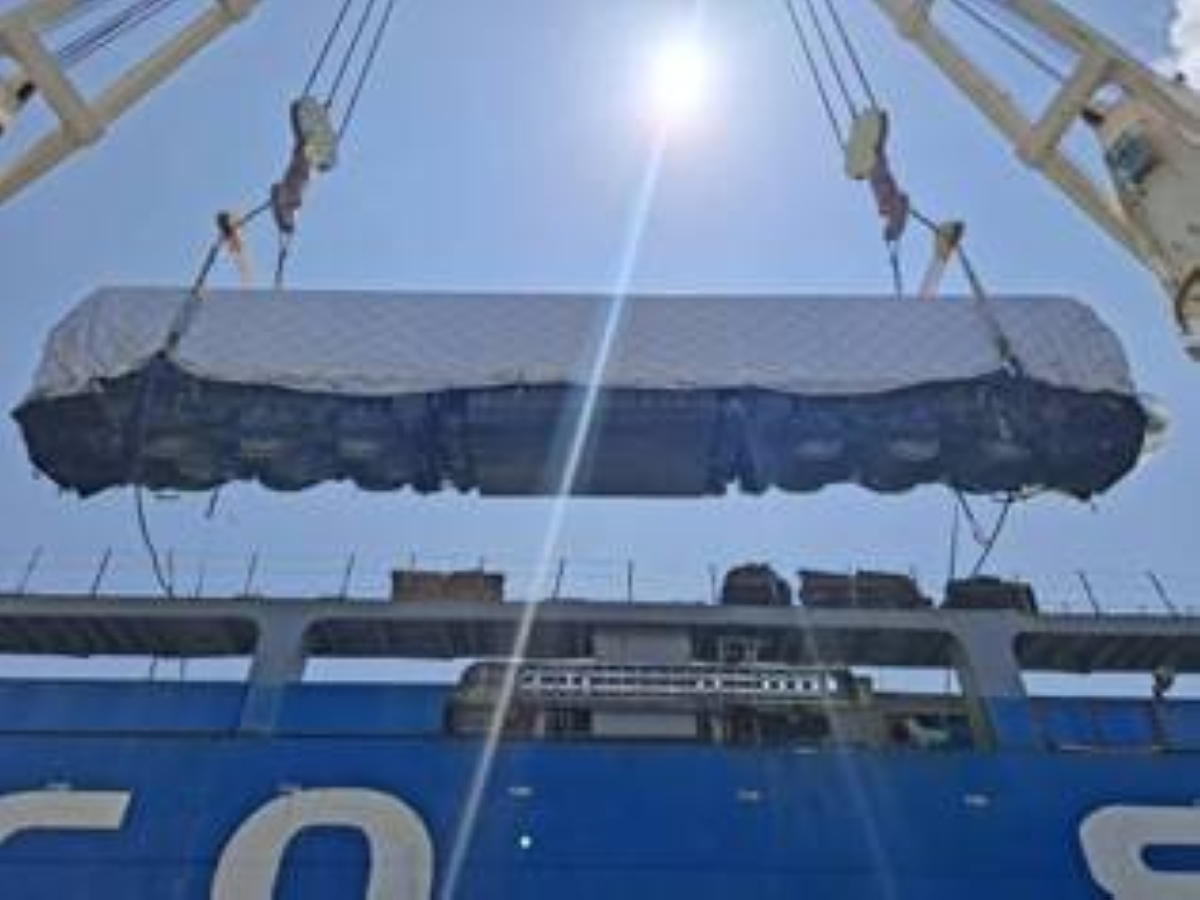

Canyon Resources has taken a concrete step toward first production at its Minim Martap bauxite project in Cameroon. Seven locomotives arrived at the Port of Douala in June, marking the start of a 6-8 week commissioning and training program. The first 60 of 160 rail wagons are due in mid-August, with the rest following by late Q3.
Stage 1 rail capacity is pegged at roughly 35,000 wet metric tonnes per month. That is the baseline for the company's initial production ramp and first export target in Q4 2026. Trial mining is expected to begin in Q3, subject to final community discussions, which should let Canyon build ore stockpiles ahead of the logistics chain going live.
The company recently raised its stake in Camrail, Cameroon's primary rail operator, from 9.1% to 26.9%. That gives it more say over bauxite transport, the PQ2 rail upgrade, and the broader mine-to-port chain. The ore haulage road, inland rail facility, and port dredging are all scheduled for completion late in Q3, just before first shipment.
Stage 2 is a bigger question. Canyon needs an additional US$160 million in funding to add 15 locomotives and 400 wagons, which would lift monthly capacity to about 105,000 wMt by early Q3 2027. Without that money, production stays at the Stage 1 rate. The company said it is in funding discussions but gave no timeline for a close.
Managing Director Peter Secker said Canyon will be "producing and shipping bauxite before the end of 2026, establishing our position as a supplier of this critical mineral to global markets." He added that the company is "committed to building on that foundation as we progress funding discussions to support the ramp-up of production."
Mark Hohnen will step down as Non-Executive Chairman and Director effective August 25, 2026. The board credited him with securing the mining license and advancing Minim Martap to near-production status. A succession update is due later.
Minim Martap holds a JORC Ore Reserve of 144 million tonnes at 51.2% Al2O3 and 1.7% SiO2, with a total Mineral Resource of 1.1 billion tonnes at 45.3% Al2O3. The deposit ranks among the world's highest-grade bauxite sources, which matters for the economics of shipping from West Africa to Atlantic Basin refineries.
Two milestones define the next six months. First, the commissioning of the rail fleet and arrival of all 160 wagons by late Q3. Second, the US$160 million funding round. Without it, the project plateaus at 35,000 wMt per month. With it, Canyon can scale to a rate that makes the logistics investment pay off. The community discussions for trial mining are the third variable – any delay there pushes the stockpile build and first shipment into 2027.
Sea freight rates, which spiked after recent Gulf disruptions, are slowly returning to early 2026 levels, Secker noted. That helps the margin math for a new Atlantic Basin bauxite supplier.
